PK0-004 · Question #123

During a project, the project manager discovers there is insufficient time allotted for quality control. The project manager prepared to submit a revised schedule to the CCB. Given the attached…

The correct answer is B. 16 days. You need to add a day for Tasks 1, 3 ,4 and 5 (critical path items) and the total days (not including the weekends) is 16.

Tools and documentation

Question

During a project, the project manager discovers there is insufficient time allotted for quality control. The project manager prepared to submit a revised schedule to the CCB. Given the attached chart, which of the following is the critical path if one day is added to each task for quality control?

Exhibits

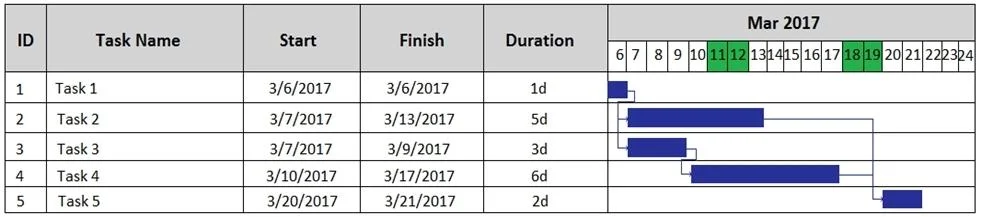

PK0-004 question #123 exhibit 1
PK0-004 question #123 exhibit 2
PK0-004 question #123 exhibit 3

Options

  • A12 days
  • B16 days
  • C17 days
  • D22 days

How the community answered

(30 responses)
  • A
    30% (9)
  • B
    47% (14)
  • C
    7% (2)
  • D
    17% (5)

Explanation

You need to add a day for Tasks 1, 3 ,4 and 5 (critical path items) and the total days (not including the weekends) is 16.

Topics

#critical path analysis#schedule adjustment#quality control#Gantt chart
