MB-335 · Question #173
Drag and Drop Question A manufacturing company uses Dynamics 365 Supply Chain Management. The company operates three eight-hour shifts per day, Monday through Friday. The company purchased equipment f
The correct answer is Add the machine as a resource and set the Exclusive checkbox to Yes.; Create a capability for the machining functions and assign it to the machine.; Assign the machine resource to the route operation and approve the route version.; Assign a working time calendar to the resource.. Explanation: Configuring a New Machine Resource in D365 Supply Chain Management Scenario Summary The machine has two critical constraints driving configuration choices: Must be monitored by a worker at all times → drives the Exclusive flag choice Must not overload capacity → addr
Question
Drag and Drop Question A manufacturing company uses Dynamics 365 Supply Chain Management. The company operates three eight-hour shifts per day, Monday through Friday. The company purchased equipment for a new process that cannot be performed with existing equipment. This specialized equipment performs only this unique task. The machinery must always be monitored and controlled by a worker. The machine must be added to the existing production line and be ready as soon as possible. Future planned production orders must not overload the running maximums of the new machine. You need to configure the system. Which four actions must you perform in sequence? To answer, move the appropriate actions from the list of actions to the answer area and arrange them in the correct order. Answer:

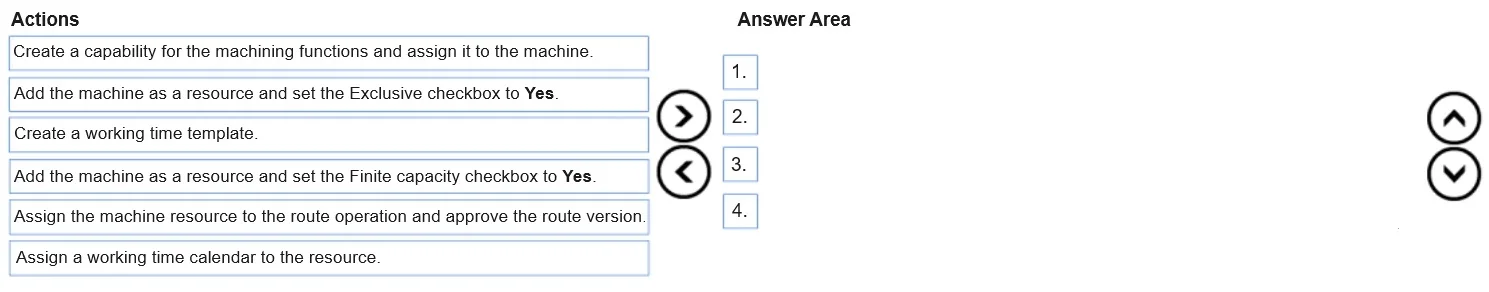

Exhibit
Answer Area
Drag items
Correct arrangement
- Add the machine as a resource and set the Exclusive checkbox to Yes.
- Create a capability for the machining functions and assign it to the machine.
- Assign the machine resource to the route operation and approve the route version.
- Assign a working time calendar to the resource.
Explanation
Explanation: Configuring a New Machine Resource in D365 Supply Chain Management
Scenario Summary
The machine has two critical constraints driving configuration choices:
- Must be monitored by a worker at all times → drives the
Exclusiveflag choice - Must not overload capacity → addressed via working time calendar
- Must join the production line ASAP → drives urgency of route assignment
Why These Four Items (Not the Others)
Excluded: "Add the machine as a resource and set the Finite capacity checkbox to Yes." This is the most common trap. Finite capacity controls whether the scheduler respects capacity limits during planning runs. The scenario's "monitored by a worker" requirement maps specifically to Exclusive, not Finite capacity. Exclusive means the resource is locked to a single job at a time and requires dedicated human attention. You can only pick one - Exclusive is correct here.
Excluded: "Assign a resource group to the machine." Resource groups are organizational/reporting containers. While common in practice, they are not required to make the machine operational, linkable to a route, or schedulable. The four correct steps cover the minimum required path.
Step-by-Step Sequence
Step 1 - Add the machine as a resource and set the Exclusive checkbox to Yes
The resource record must exist before anything else can reference it. This is the non-negotiable starting point.
Setting Exclusive = Yes reflects the requirement that the machine "must always be monitored and controlled by a worker." In D365 SCM, Exclusive means the resource cannot be split across multiple jobs simultaneously - it is reserved for one operation at a time with a dedicated operator. Without this flag, the scheduler could theoretically assign the machine to overlapping jobs, violating the human-monitoring constraint.
Step 2 - Create a capability for the machining functions and assign it to the machine
Once the resource exists, you define what it can do via a capability. The scenario states the machine performs a unique task no other equipment can handle. A capability in D365 SCM is a tag that describes a skill or function, which can then be referenced in route operations.
This step must precede route assignment (Step 3) because the route operation needs a capability or specific resource to reference when the route version is approved. Defining capability first also enables demand-driven resource selection in future planning.
Step 3 - Assign the machine resource to the route operation and approve the route version
This is the step that "adds the machine to the existing production line." You navigate to the relevant route, assign the new resource (or its capability) to the appropriate operation, then approve the route version to activate it.
Approval is mandatory - an unapproved route version is inert. The question's urgency ("ready as soon as possible") is fulfilled here. This step logically follows Step 2 because the capability must exist to be assigned to the operation.
Step 4 - Assign a working time calendar to the resource
The company runs three 8-hour shifts Monday–Friday. By assigning this working time template to the resource, you define its maximum available capacity. This directly satisfies "future planned production orders must not overload the running maximums" - the scheduler uses the calendar to know when the machine is available and respect those boundaries.
This step comes last because the machine needs to exist (Step 1) before a calendar can be attached. It is logically separate from the route work (Steps 2–3) and addresses the capacity/planning concern rather than the operational integration concern.
Common Mistakes Summary
| Mistake | Why it's wrong |
|---|---|
| Choosing Finite capacity instead of Exclusive | Finite capacity controls planning overload; Exclusive controls dedicated-worker/single-job use |
| Including "Assign a resource group" | Not required for operational readiness; it's organizational, not functional |
| Putting calendar assignment before route assignment | The calendar is about capacity limits for future orders; route assignment is the immediate "ready ASAP" requirement |
| Skipping capability creation | Without a capability, the unique task has no formal definition and the route operation has nothing meaningful to reference |
